Accurate and timely measurement of project progress is paramount in construction project management. It provides critical insights into the overall project performance, allowing for proactive decision-making and risk mitigation. In this article, we try to explore the various methods for tracking project progress using Primavera P6 and ScheduleReader.
Overview of Primavera P6 and ScheduleReader
Primavera P6 is a cornerstone in the project management toolkit, particularly within the construction industry. This software is designed to be a comprehensive solution for planning, scheduling, resource allocation, and cost control. Its robust features allow project managers to effectively manage complex projects, ensuring they are delivered on time, within budget, and to the required quality standards.
Various benefits and uses in utilizing Primavera P6 in managing construction projects include:
- Centralized Planning: The software provides a single platform to create detailed project schedules, breaking down complex projects into manageable work packages.

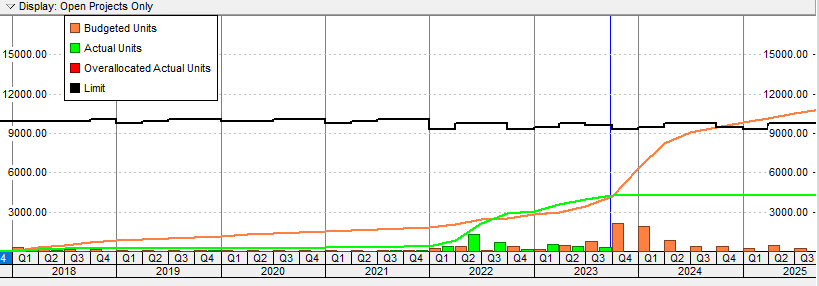

- Resource Optimization: By allocating resources efficiently, the software helps prevent overallocation and underutilization, maximizing productivity.
- Cost Control: Integration of cost data with project schedules enables effective cost management and tracking.
- Risk Management: Identification and mitigation of potential risks are streamlined through P6’s risk management features.
- Progress Tracking: Real-time monitoring of project progress against the baseline plan helps identify deviations early on.
While Primavera P6 is a powerful tool, ScheduleReader complements it by offering a user-friendly interface for viewing, analyzing, and sharing project data. It is essentially a standalone software that can open and interpret project files exported from P6.
Advantages of using ScheduleReader in addition to Primavera P6:
- Enhanced Visualization: ScheduleReader provides clear and intuitive visual representations of project data, replacing the use of PDFs and making it easier to understand complex schedules. It also provides various reports that explain the health of a schedule.
- Faster Access to Project Data: It can open large XER and XML project files quickly, as it makes no connections to database, eliminating the wait times often associated with P6.
- Simplified Sharing: Project data can be easily shared with stakeholders who may not have access to P6.
- Focus on Analysis: ScheduleReader allows users to concentrate on analyzing project performance and identifying potential issues.
- Collaboration: Through a unique “Progress Update” feature, ScheduleReader allows teams from the field to efficiently send progress updates back to the scheduler in a structured format
Setting Up for Progress Measurement in Primavera P6
Initial project setup and baseline creation are fundamental steps in establishing a robust framework for effective progress measurement. Below are the basic steps involved:

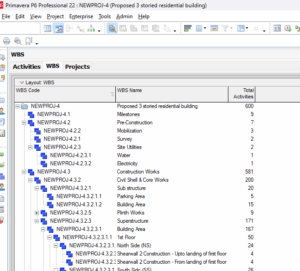

- Create the Project Structure: Break down the project into manageable components, ensuring a clear hierarchical structure with the help of the WBS (Work Breakdown Structure).
- Define specific tasks or actions required to complete the project as activities, outlining their scope and deliverables.
- Establish relationship dependencies between activities, such as predecessor-successor relationships or start-to-finish constraints.
- Specify Activity Details:
- Estimate the time required to complete each activity, considering factors like resource availability and complexity.
- Assign necessary resources (e.g., personnel, equipment, materials) to activities, specifying their quantities and costs.
- Calculate the estimated cost for each activity based on resource requirements and rates.
- Create Baseline:
- Determine the start and finish dates for activities, considering dependencies and resource constraints.
- Assign resources to activities according to their availability and requirements.
- Calculate the total project cost based on activity estimates and resource allocations.
- Create a baseline and obtain approval for the baseline plan from relevant stakeholders.

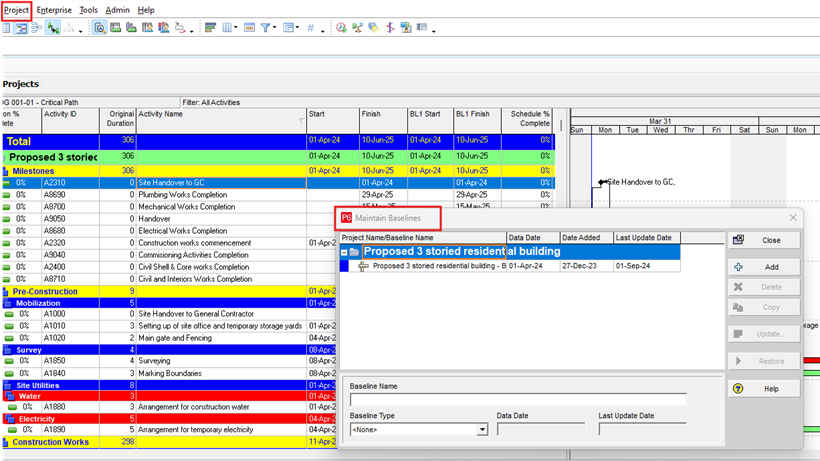

- For creating a baseline (BL)
- Go to Project
- Select maintain BL – Add – Save a copy of the current project as a new BL
- Then again go to Project – Assign BL and select the required BL
- For creating a baseline (BL)
Methods of Measuring Project Progress with Primavera P6 and ScheduleReader
- Method 1: Activity Percent Complete

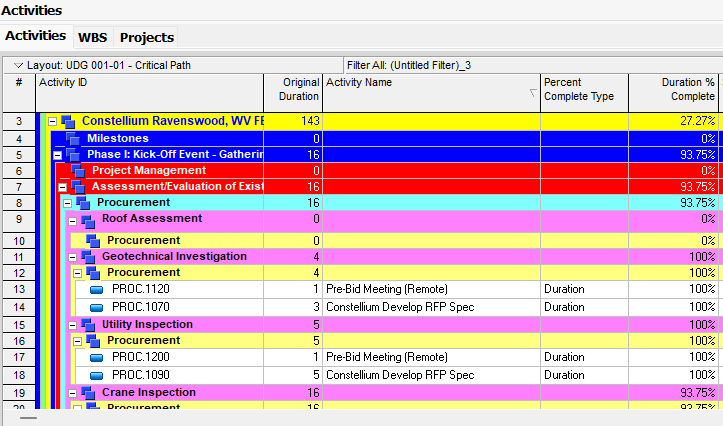

This method measures progress based on the percentage of work completed for each individual activity.

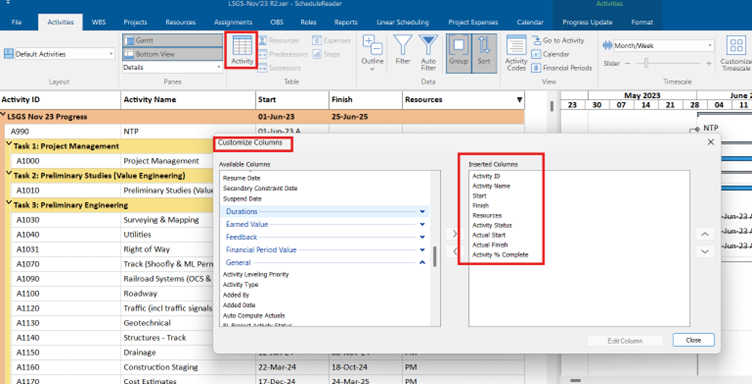

- Steps to enter and update percent complete in Primavera P6
- Open the relevant project file.
- Navigate to the “Activities” tab.
- Select the activity you want to update.
- Enter the percentage of work completed in the “Percent Complete” field.
- Examples and best practices for accurate reporting
- Regular updates: Ensure timely and accurate updates to maintain project visibility.
- Clarity: Define clear criteria for determining percent complete to avoid inconsistencies.
- Consider dependencies: Account for dependencies between activities to accurately assess overall progress.
2. Method 2: Duration Percent Complete
This method measures progress based on the percentage of time elapsed compared to the total duration of an activity.
- How to track and update duration progress
- Monitor the actual start and finish dates of activities.
- Calculate the elapsed duration.
- Determine the percentage of duration completed.
- Situations where this method is most effective
- This method is most effective for activities with a fixed duration and where progress can be measured in terms of time elapsed.

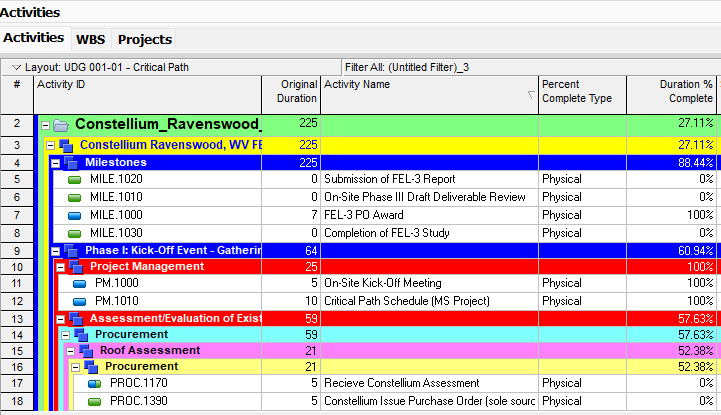

3. Method 3: Units Percent Complete
- This method measures progress based on the completion of specific units of work (e.g., cubic meters of concrete, meters of pipe).
- Detailed process for measuring progress based on units
- Define units of work for each activity.
- Track the completion of units.
- Calculate the percentage of units completed.
- Tips for using this method effectively
- Ensure clear definitions of units and accurate tracking to avoid discrepancies.
4. Method 4: Physical Percent Complete
- This method assesses progress based on the physical completion of work, often using visual inspections or measurements.
- Techniques for assessing physical progress
- Photographs: Document progress visually.
- To observe construction progress week by week, it is advised that photographs be taken from the same spots each time.
- Measurements: Measure the extent of completed work.
- Inspections: Conduct regular inspections to verify progress.
- Photographs: Document progress visually.
- Application of this method in construction projects
- This method is commonly used where physical evidence of progress is readily available.
5. Method 5: Earned Value Management (EVM)
EVM assesses project progress by comparing planned work (Planned Value) with actual work completed (Earned Value) and costs incurred (Actual Cost).

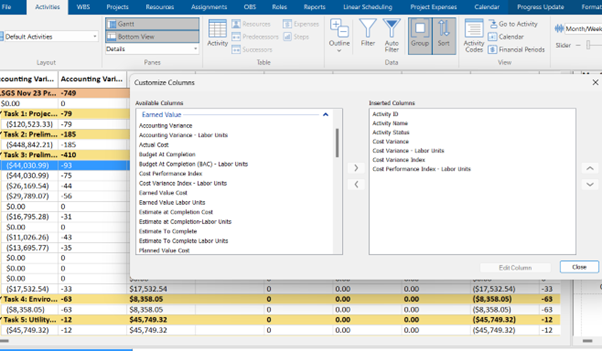

- Calculating and analyzing key EVM metrics
- Schedule Performance Index (SPI): Earned Value / Planned Value – Measures schedule efficiency (SPI > 1 indicates ahead of schedule).
- Cost Performance Index (CPI): Earned Value / Actual Cost – Measures cost efficiency (CPI > 1 indicates under budget).
- Schedule Variance (SV): Earned Value – Planned Value – Quantifies the difference between planned and earned value.
- Cost Variance (CV): Earned Value – Actual Cost – Quantifies the difference between earned and actual costs.
- EVM in ScheduleReader
- ScheduleReader can be used to analyze EVM metrics.
6. Method 6: Milestone Tracking
Milestones are critical checkpoints in a project timeline that mark significant achievements or deliverables. They serve as a benchmark to assess project progress and identify potential deviations from the planned schedule.
Here’s how milestones contribute to project progress measurement:
- Visibility of Progress: Milestones provide a clear visual representation of project advancement. By tracking the completion of milestones, stakeholders can easily understand the project’s overall status.
- Early Detection of Issues: If a milestone is not met on schedule, it can signal potential problems or delays. This early detection allows for proactive measures to address the issues and prevent further setbacks.
- Risk Management: Milestones can be used to identify potential risks and challenges. By monitoring progress against milestones, project managers can assess whether the project is on track to meet its objectives.
- Resource Allocation: Milestones help in determining the allocation of resources. Knowing the timing of milestones can guide the distribution of resources to ensure timely completion of critical tasks.
- Setting up and updating milestones in Primavera P6
- Create Milestones: In Primavera P6, you can create milestones by defining their name, description, and start and end dates. Milestones typically have a duration of zero days.
-
- Link Milestones to Activities: Connect milestones to relevant activities in your project schedule. This helps visualize the relationship between milestones and the tasks that contribute to their achievement.
- Update Milestone Status: As the project progresses, update the status of milestones to reflect their completion or progress. This can be done by manually changing the status or using automated tools.
- Benefits of using milestone tracking for overall progress
Tracking milestones offers numerous benefits for overall project progress:
- Improved Decision Making: By monitoring milestones, project managers can make informed decisions about resource allocation, risk mitigation, and schedule adjustments.
- Enhanced Communication: Milestones provide a common language for discussing project progress with stakeholders. This can improve communication and alignment within the project team.
- Increased Accountability: Milestones can be used to assign accountability for specific tasks and deliverables. This can motivate team members to meet their commitments.
- Enhanced Stakeholder Satisfaction: Regular updates on milestone progress can help keep stakeholders informed and satisfied with the project’s advancement.
7. Method 7: Progress Update – unique ScheduleReader feature
- A two-way communication channel between the scheduler using Primavera P6 and the onsite project team
The scheduler, using Primavera P6, creates the schedule with the required progress data, such as:
-
- Activity completion percentage
- Actual start and end dates
- Resource allocation
- Any relevant notes or comments
With ScheduleReader, users can view the schedule. First, we need to make sure we add all the necessary fields from the Activity table.

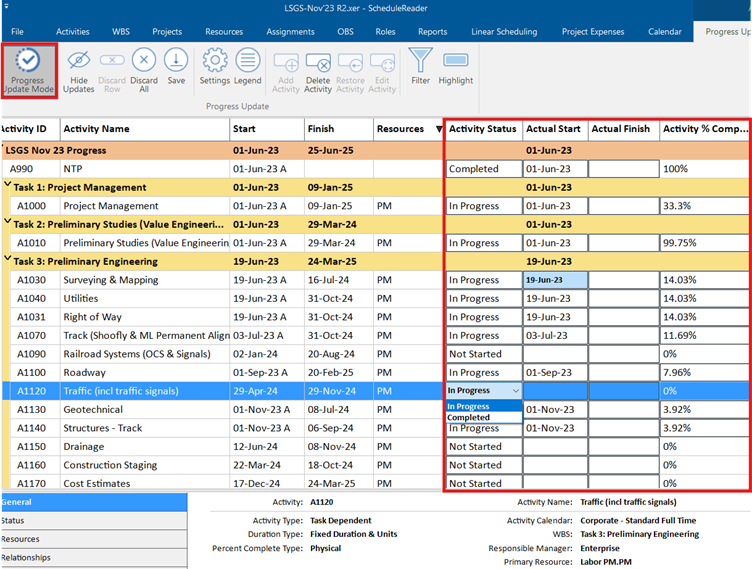

To edit an activity in the view, we should enable the “Progress Update” mode, which will highlight the editable fields with a double cell border. Update proposals can then be made on the relevant activity. At the end we need to click save button to save the updates.
The updates are saved in an Excel file that contains the all the update proposals, and handed over to the scheduler who can further incorporate the updates into the main schedule.
The updated schedule can then be shared with the stakeholders after making necessary changes, including specific information and formatting as needed.
Visualizing Progress in Primavera P6 and ScheduleReader

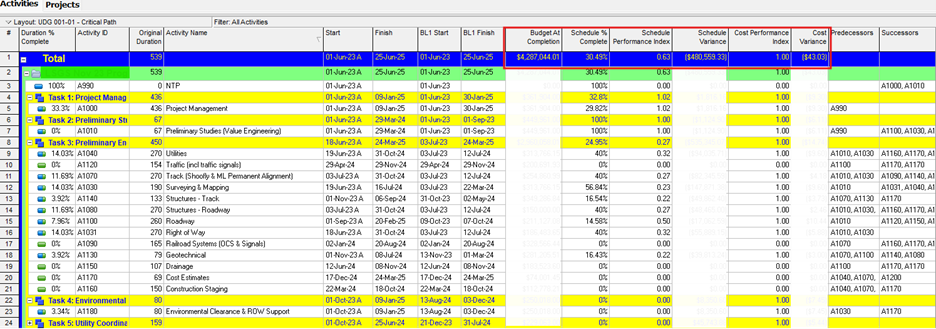

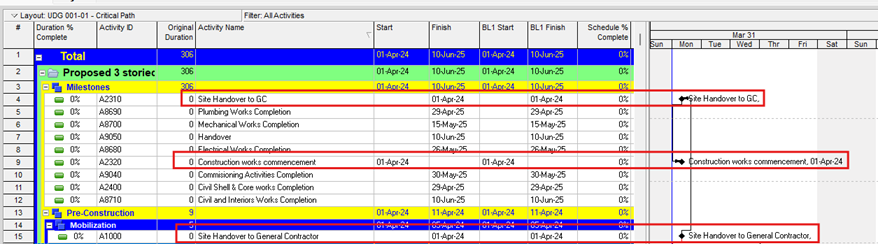

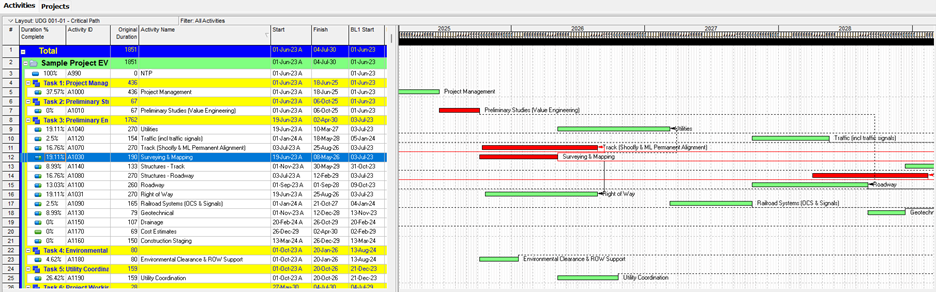

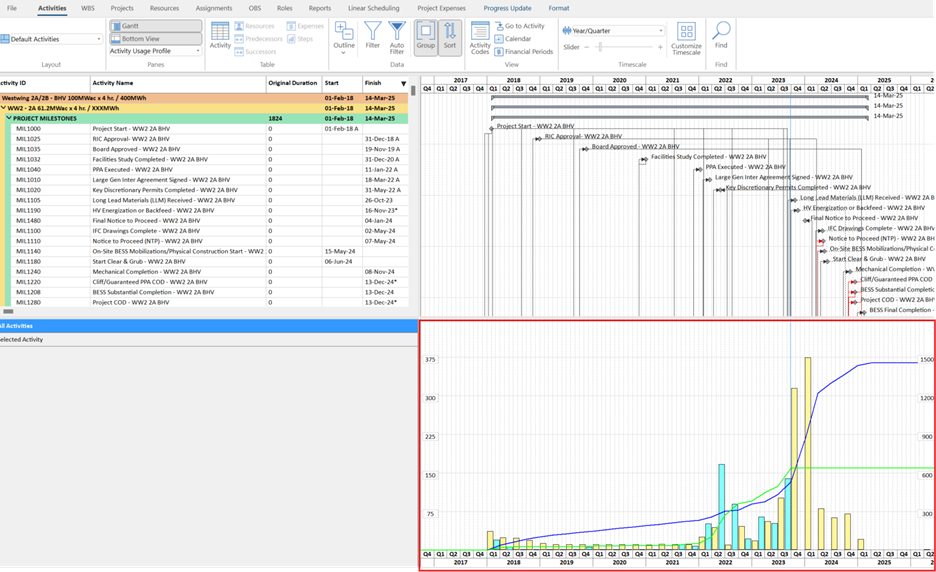

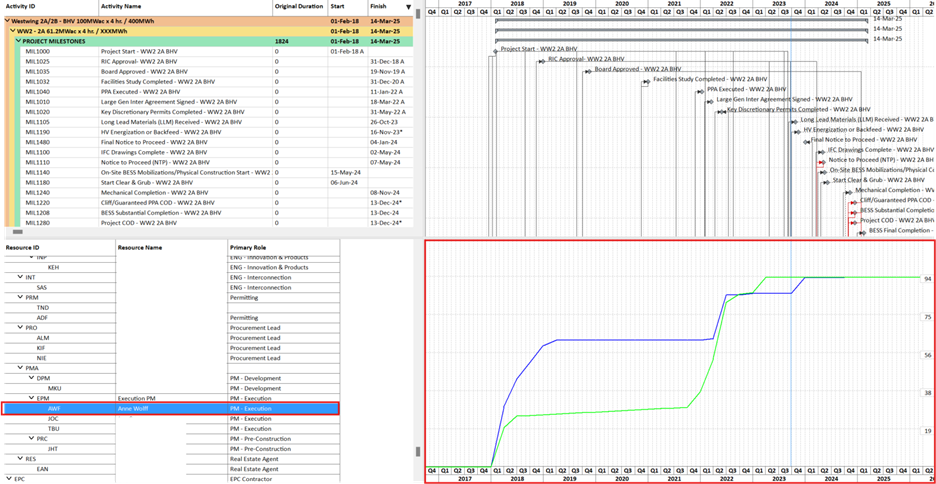

Gantt Charts and Baselines

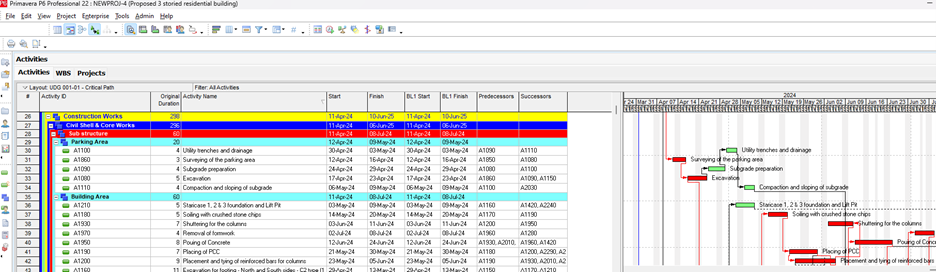

Gantt charts provide a visual representation of project activities, their duration, and their relationship to each other. The horizontal axis represents time, and the vertical axis lists activities. The chart shows the planned start and end dates of each activity, as well as their actual progress.
- Customizing Gantt charts for better progress visualization
To enhance visualization, you can customize Gantt charts in both Primavera P6 and ScheduleReader. This includes:
-
- Color-coding: Assign different colors to activities based on their status (e.g., completed, in progress, not started).
- Adding milestones: Highlight key milestones to track progress at specific points in the project.
- Filtering activities: Show only relevant activities to avoid clutter.
- Analyzing Baselines
- A baseline is a snapshot of the original project schedule. By comparing the baseline to the current schedule, you can identify variances and assess project performance. ScheduleReader can also visualize the project baselines and can be used for this type of project analysis.
S-Curves
- Generating and using S-curves for progress tracking
S-curves are cumulative progress curves that show the total amount of work completed over time. They can be generated in both Primavera P6 and ScheduleReader. By comparing the actual S-curve to the planned S-curve, you can assess project performance and identify potential issues.
Understanding the Significance of S-Curves: S-curves are valuable for:
- Identifying deviations: Significant deviations from the planned S-curve can indicate schedule delays or accelerated progress.
- Forecasting completion: By analysing the shape of the S-curve, you can estimate the project’s expected completion date.
- Assessing resource utilization: S-curves can help you identify whether resources are being used effectively.
Dashboards and Reports
- Setting up dashboards in ScheduleReader :
ScheduleReader allows you to create customized dashboards that provide a visual overview of project progress. You can add various widgets, such as Gantt charts, S-Curves, and performance indicators.

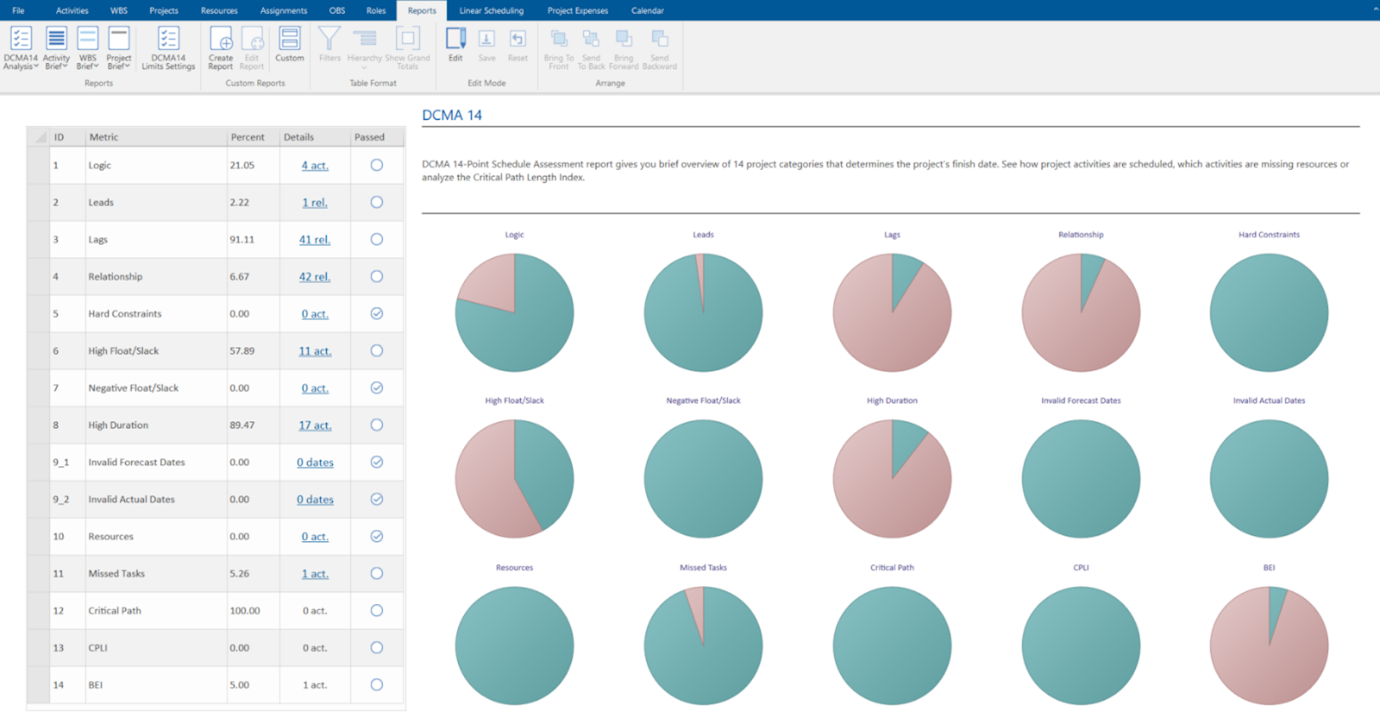

- DCMA 14 checklist

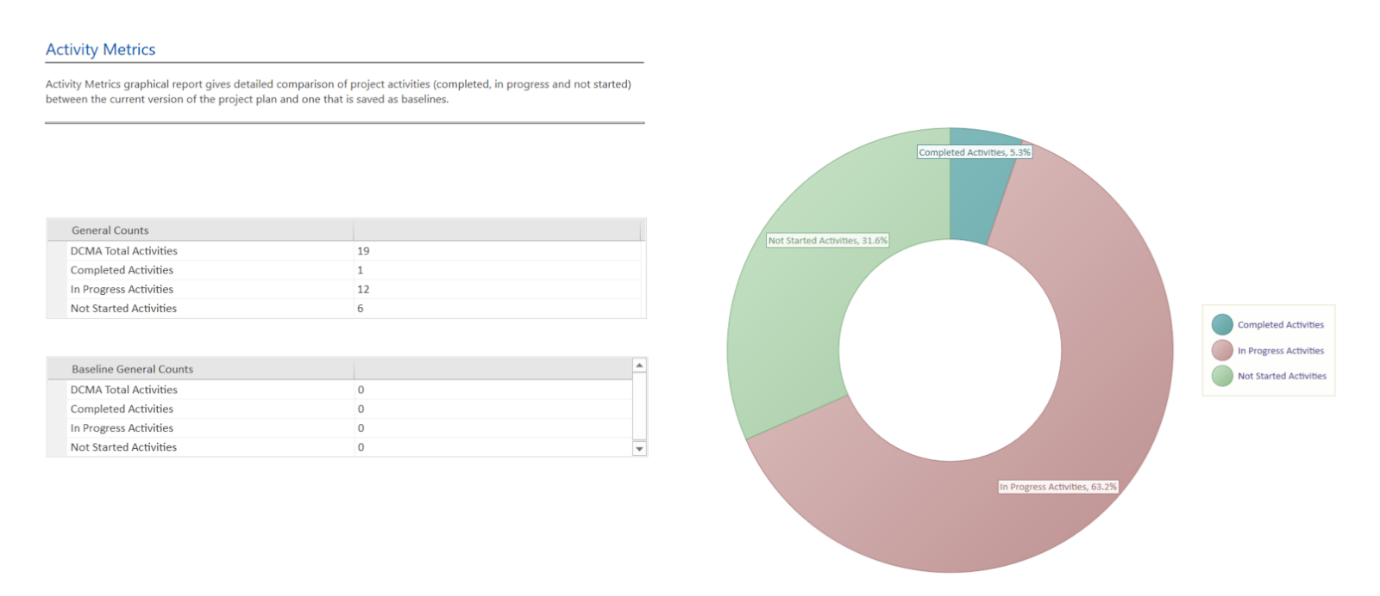

2. Activity Metrics Report

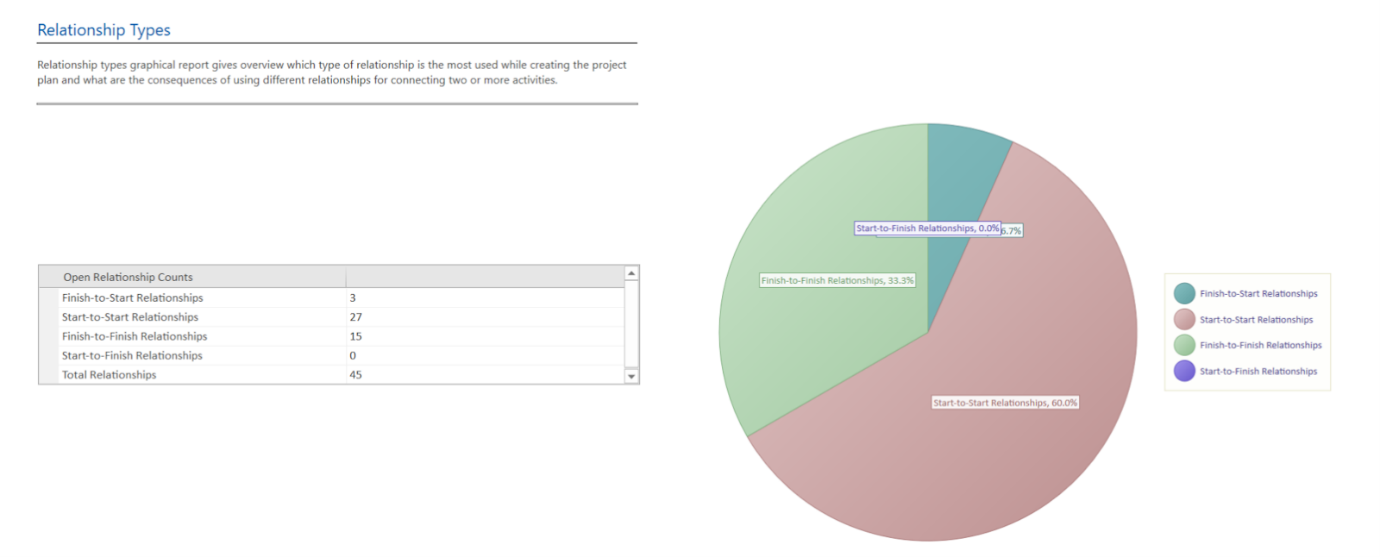

3. Relationship Types

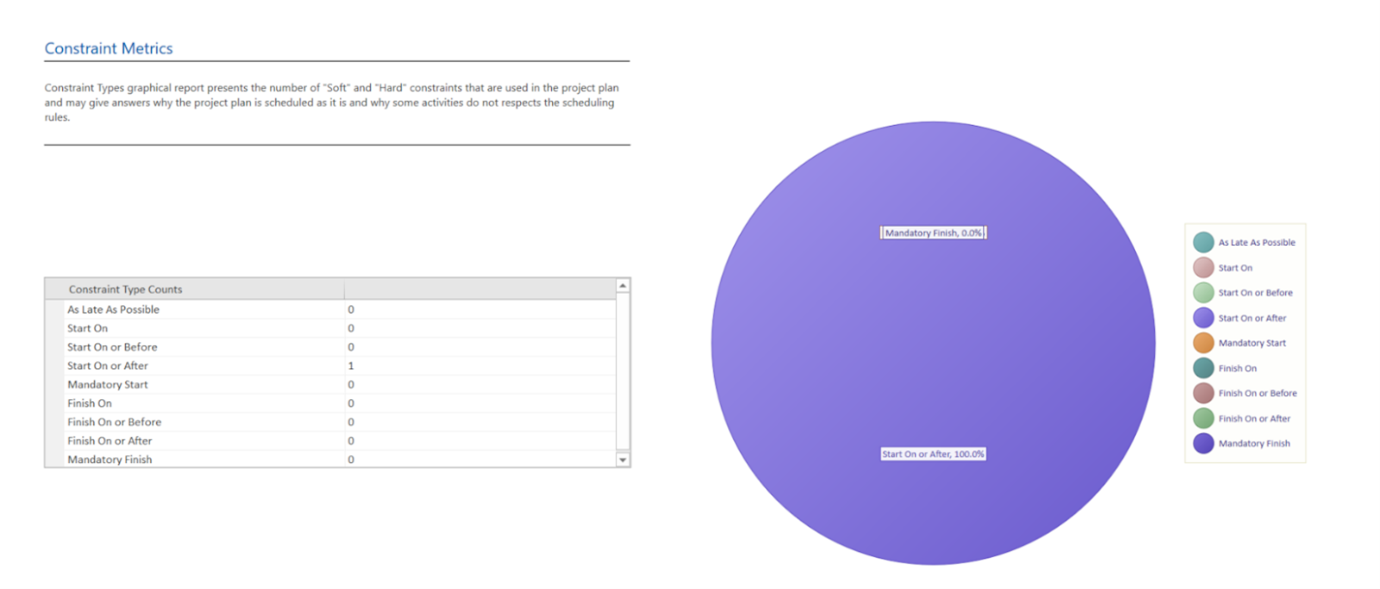

4. Constraint Metrics

5. Activity Units

6. WBS Cost
- Creating and customizing progress reports: Both Primavera P6 and ScheduleReader offer a variety of report templates that can be customized to meet your specific needs. You can include information such as:
- Project summary: Overall project status, key milestones, and completion percentage.
- Activity status: Detailed information on each activity, including progress, start and end dates, and resource allocation.
- Cost and schedule performance: Variance analysis, earned value metrics, and critical path analysis.

In ScheduleReader, you can click on the Reports – Click Custom Report and select the required type, to create a custom report satisfying your needs.

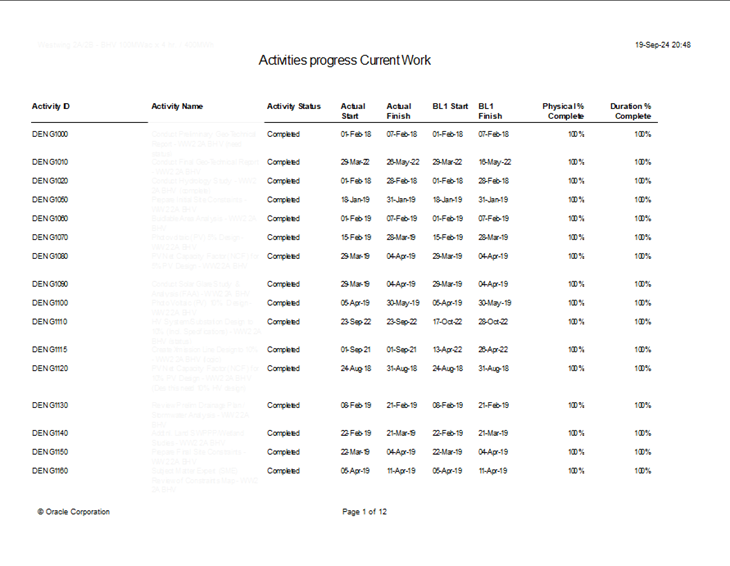

- Examples of useful progress reports
- Weekly status reports: Provide a snapshot of project progress and identify any potential issues.
- Milestone reports: Highlight the achievement of key milestones and assess project performance.
- Variance reports: Analyse deviations from the baseline plan and identify corrective actions.
Best Practices for Accurate Progress Measurement
- Regular updates and consistent monitoring: Ensure that project status is updated regularly and consistently to maintain accurate progress tracking.
- Ensuring data accuracy and reliability: Validate data entered into the project management software to ensure accuracy and reliability.
- Training team members on progress measurement techniques: Provide training to project team members on how to accurately report progress and use project management tools effectively.
- Using adept software tools for comprehensive tracking: Choose a project management software that offers features for progress tracking, such as Gantt charts, S-curves, dashboards, and reports.
By following these best practices and leveraging the capabilities of Primavera P6 and ScheduleReader, you can effectively track project progress, identify potential issues, and make informed decisions to ensure successful project delivery.
